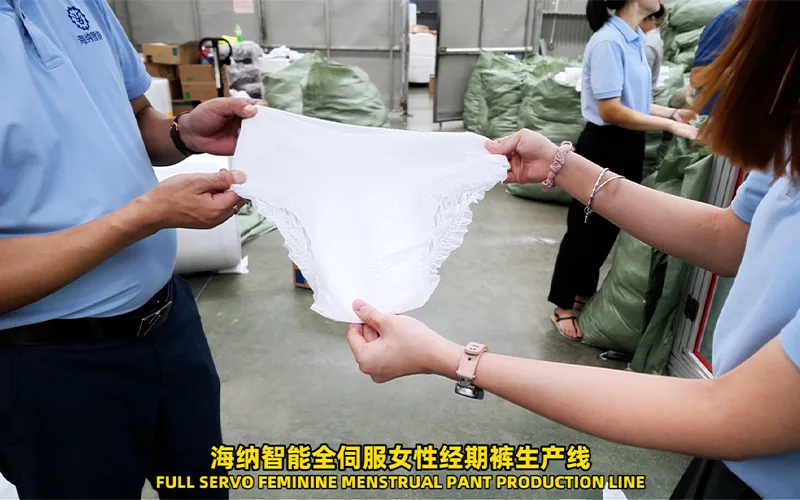

Author:Haina Machinery Factory FROM:Diaper Machinery Manufacturer TIME:2026-09-29
Approve samples from a lady diaper manufacturing machine only when they come from the agreed machine configuration, production-intent materials, controlled recipe, and documented run conditions. Appearance alone is insufficient. The supplier checklist should cover sample identity, product drawings, material lots, dimensional methods, core distribution, elastic and side-join checks, visible defects, packaging, online inspection, run stability, and changeover evidence. Buyers should also record who measures each characteristic, which instruments are used, how samples are conditioned, and how nonconformities are closed. This converts sample approval from a subjective review into traceable evidence for FAT and site commissioning.
Sample approval must state what is being approved. A product-development sample may confirm dimensions and material construction but say little about sustained machine operation. A setup sample may show that tooling can make the basic shape. A FAT sample should be linked to the contracted line, materials, recipe, speed condition, inspection status, and run segment. Do not use one label for all three.
Create an approval protocol before samples are made. List every launch size and variant, planned material combination, package format, sampling point, sample quantity, conditioning period, test location, responsible person, and disposition authority. Define which tests occur at the supplier factory and which require the buyer's laboratory or a later site acceptance stage.
Use a controlled product drawing and bill of materials as the baseline. Mark revision numbers on the sample label and report. If a sample uses substitute materials, identify every substitution and explain which results remain valid. Approval of a substitute should not silently approve a different commercial product.

Each sample group needs a unique identifier. Record product code, size, drawing revision, bill-of-material revision, date, time, machine recipe, actual operating condition, run segment, material supplier, lot, roll identification, and operator. Mark whether the sample was taken during startup, stable running, after a splice, after a stop, or after a size change.
Keep material certificates or supplier data only as supporting documents; verify that the physical rolls used match the recorded identity. Record width, roll diameter, core size, winding direction, and any observed damage before loading. For pulp, SAP, elastic, adhesives, and other non-roll inputs, use batch or container identification where available.
Traceability must survive packaging and shipping. Place samples in labeled, sealed groups that prevent mixing or distortion. Separate accepted references, test samples, destructive-test samples, and retained samples. Photograph the label and the intact sample set before dispatch. Both parties should hold matching retained references when practical.
Wearable absorbent products change shape after cutting because elastics recover and soft webs relax. Define whether each measurement is taken stretched, relaxed, flattened, unfolded, opened at the side seam, or conditioned for a specified period. State how force is applied during extension and where the measurement points sit.
Use a drawing that identifies product length, waist width, crotch width, leg opening, core length and width, core position, elastic zones, side-join width, fold position, and cutoff alignment. Add tolerances only when they are based on an approved product requirement and realistic material behavior. Do not invent tolerance values during the supplier visit.
Document instruments and their fitness for use. Rulers, scales, thickness gauges, force testers, templates, imaging systems, and laboratory devices serve different properties. Record calibration or verification status according to the buyer's quality system. Include enough detail that another trained person can repeat the method.
Sample size and sampling frequency should reflect the decision. First-piece approval may need focused dimensional checks. A sustained run needs samples distributed through time. A changeover review needs samples before the stop, at restart, during adjustment, and after release. Averaging results can hide individual critical defects, so retain both individual data and summaries.
Open selected products carefully to inspect the absorbent core. Measure total and zoned mass using the approved method, then examine contour, edge definition, position, wrapping, compression, and visible distribution. Record material loss caused by disassembly. If a distribution method is not yet approved, report observations without converting them into unsupported numeric acceptance claims.

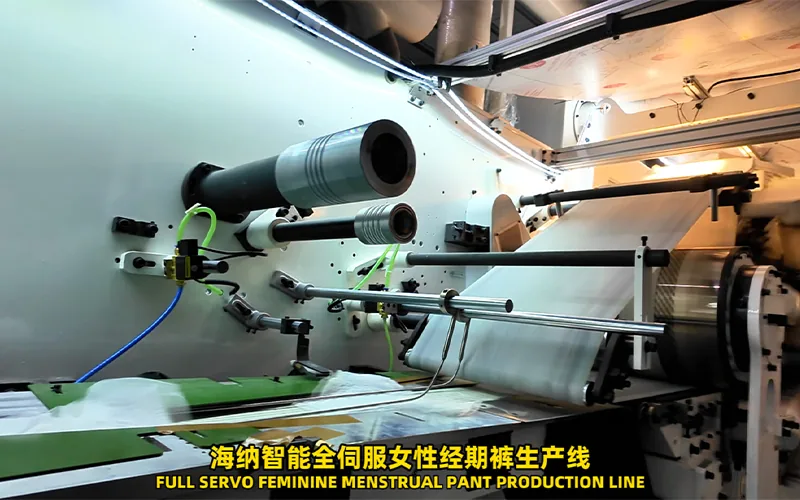

Review the chassis as a registration system. Confirm the position of topsheet, backsheet, barriers, waist materials, leg elastic, and core against the common centerline. Look for wrinkles, exposed adhesive, missing components, folded barriers, damaged film, uneven leg contours, contamination, or distortion created during folding.
Side joins should be checked on both sides and at multiple points in the run. Inspect alignment, continuity, width, appearance, edge feel, intended opening behavior, and any damage near elastic or film. Use the approved strength or opening method. A join that looks continuous can still vary through its length or behave differently after material conditioning.

Cosmetic review covers characteristics visible without destructive testing: fold consistency, print orientation where used, contamination, wrinkles, cut quality, exposed components, adhesive marks, seal appearance, and package presentation. Create defect photographs and written definitions before FAT so inspectors do not negotiate every judgement beside the machine.
Functional review may include core distribution, absorption-related laboratory tests, backsheet integrity, bond or join behavior, elastic recovery, fit-related dimensions, wrapper opening, and package seals. Each test must have a controlled method and clear responsibility. Some results may depend strongly on material selection and conditioning, so identify what the equipment supplier can control.
Machine evidence is another category. It includes stable operation, stops, alarm response, inspection challenges, rejection, splice handling, recipe control, changeover, and downstream interface. A good sample cannot compensate for repeated unrecorded stops, just as a stable run cannot compensate for products outside the approved requirements.
Request the run log associated with every approval set. Record startup time, acceleration, actual operating speed, stable-run period, planned and unplanned stops, cause categories, material splices, adjustments, rejects, inspections, and end time. Keep design speed separate from the demonstrated FAT condition.
Observe how samples are selected. They should follow the agreed sampling plan rather than being chosen only after offline screening. Where automatic inspection is included, link the sample period to inspection status and challenge results. Confirm that the physical rejection system removes the intended product and that reject counts can be reconciled.
Review downstream effects. Counting, stacking, bagging, sealing, coding, and case handling can deform products or create package defects after the converting section has produced acceptable pieces. Define whether sample approval covers loose products, packed products, or both. Record any manual handling used during the test.
For a HAINA menstrual pants machine project, buyers should place the approved sample protocol beside the product specification and FAT plan. That allows the same references to support later installation and operator training.

| Evidence group | Approve when | Hold when | Required record |
|---|---|---|---|
| Identity and traceability | Samples match approved revisions materials and run segment | Labels are missing or substitute materials are unexplained | Sample label material log and recipe reference |
| Dimensions and construction | Approved methods show results within the product requirement | Method conditioning or measurement points are disputed | Individual data sheets and annotated drawing |
| Core and leak features | Core barriers elastics backsheet and joins meet defined checks | Destructive tests or functional methods are incomplete | Inspection report test results and retained products |
| Run context | Samples represent the agreed operating and sampling conditions | Products were selected without a traceable run log | Stop log speed record splice log and sample times |
| Packaging | Packed products meet count fold seal code and presentation criteria | Manual substitution hides an untested line interface | Packing run record and package inspection |
The table supports three dispositions: approved, conditionally approved, and rejected. Conditional approval should name the exact deviation, affected characteristics, temporary limitation, corrective action, owner, due condition, and required retest. Avoid open language such as improve quality later.
Supplier closeout checklist
When a correction changes one process, check connected characteristics. Moving a core can affect cutoff margin and fold. Changing elastic tension can affect dimensions and side-join alignment. Adjusting join energy can affect opening behavior and material feel. The retest scope should follow the technical impact, not only the original failed row.
Preserve the final baseline in a handover package. Include approved drawings, bill of materials, measurement procedures, instruments, sample data, recipes, tooling list, defect images, run logs, accepted samples, open items, and signatures. Site teams can then compare commissioning output against a known reference instead of relying on memory.

They can approve limited product-development characteristics, but the record must state the temporary configuration. Final FAT samples should come from the contracted machine scope and agreed run conditions.
There is no universal count. Define enough samples to represent startup, stable running, splices, stops, each launch size, changeover, destructive tests, packaging, and retained references.
Assign each test in advance. Joint measurements are useful for critical characteristics, while buyer laboratory tests may be needed for methods or instruments unavailable at the supplier site.
No. Sample quality and machine stability are related but separate evidence. Review run duration, speed condition, stops, rejects, inspection, material changes, and sampling method.
